Over the past 4 weeks I’ve started to think of myself as being a person ‘of no fixed abode’ and it’s not a great feeling. We came back from Cape Town hoping to move into our new house by the beginning of June. That moved to late June and in desperation I actually booked the movers for July the 3rd which is next Friday. For a while last week it looked as though it might be possible, but since my site visit this afternoon, I have started to doubt the wisdom of that.
We’ve been really fortunate in having the use of a friend’s lovely home set high up on Westcliff Ridge with beautiful views out over the densely forested northern suburbs of Johannesburg and sunsets so spectacular as to take our breath away. Our plan was to be installed – even if camping – in our new house by the time our host returns from his travels on the 4th of July.

Johannesburg winter sunset from Westcliff.

Daisy exploring the 4th floor of our current ‘guesthouse’.
Relations with the contractor have been strained – to say the least – for some time now. It seemed to take a very strongly worded email though, to get him to realise the extent of our discontent and work has speeded up over the last ten days but it’s too little too late to be in any way redemptive.
The most serious delays have been caused by the company contracted by Esprit to do all the electrical work. Weeks have passed with no electricians on site and no amount of pleading and negotiating has made any difference at all. It has become clear that there are issues between the two companies and it is difficult to change ‘electric horses’ midstream. As with all building projects, the failure of one team to keep to their schedule has a domino effect as each sub-contractor is in some way dependent on the one before him so we have seen one deadline after another pass unheeded. And I have become used to people who appear to be able to make promises with not the slightest intention of ever keeping them.

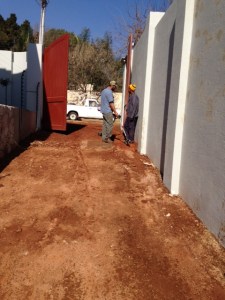

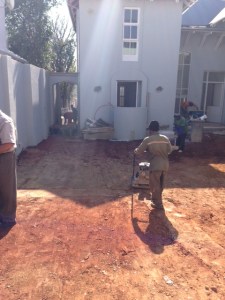

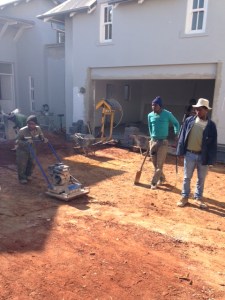

So this is where we are: The brick paving company scheduled to pave the driveway and pathway down to the park, having been deferred several times, are supposed to arrive tomorrow. What I could see of the driveway this afternoon – those bits that were visible under piles of rubble and rubbish, made that seem like something of a pipe dream. So we’ll see. The paving job is expected to take a minimum of four days.
Inexplicably, one lone painter has been tasked with the painting of the entire house both inside and out. He is nowhere near finished and already there are areas he’ll have to redo.
Because of a lack of supervision, the gateway into the park was built and demolished twice before being completed. This delayed the gate manufacturer from being able to take final measurements.

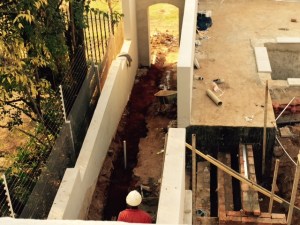

Arched gateway to park. 3rd time lucky.
On the right side of the photo above you can see the start of steps which will lead from the raised lawn down to the path. You can also see the western end of the pool. Except for the corners, all the coping tiles around the pool are in place. Curtis pools have been very reliable so far and have done their best to work around all the date changes.
The prolonged absence of electricians has delayed the installation of the generator, the pool pump and the water tank pump.

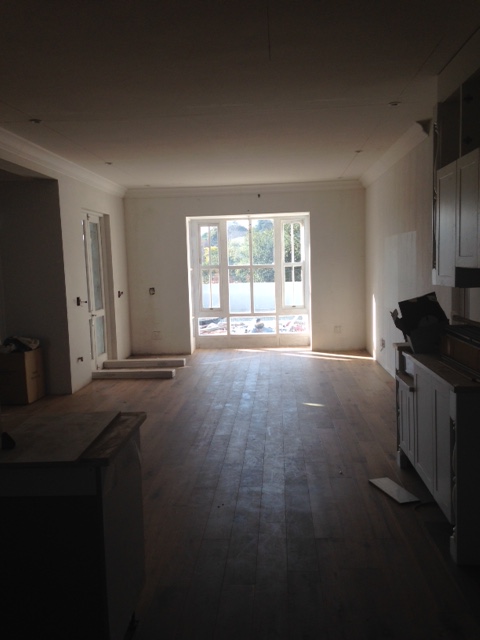

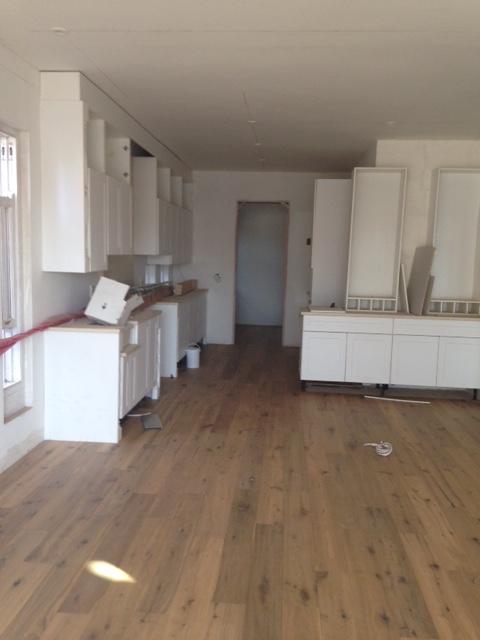

The installation of the kitchen has ground to a halt while we wait for the electrical work to be completed.

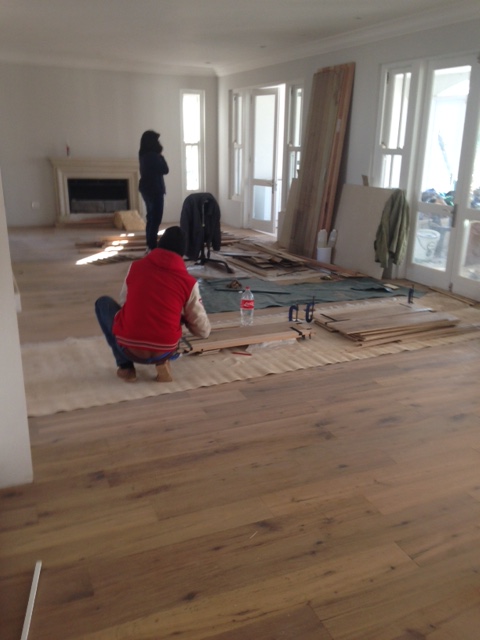

One the plus side, Oggie, the flooring company, after being deferred several times, was able to start this week although not in the peaceful, cleared environment I’d hoped for. They have laid the floors in the library and most of the living room and hope to get to the kitchen tomorrow. They have also almost completed the upstairs flooring and it’s all looking beautiful. Now we have to hope that the wood doesn’t get damaged by workmen – who should have been finished weeks ago – tramping all over it. They still have to do the stairs but until all other upstairs work is done, they are unable to start.

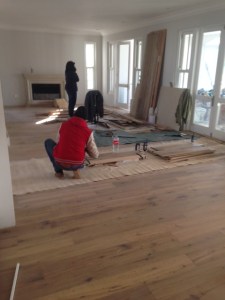

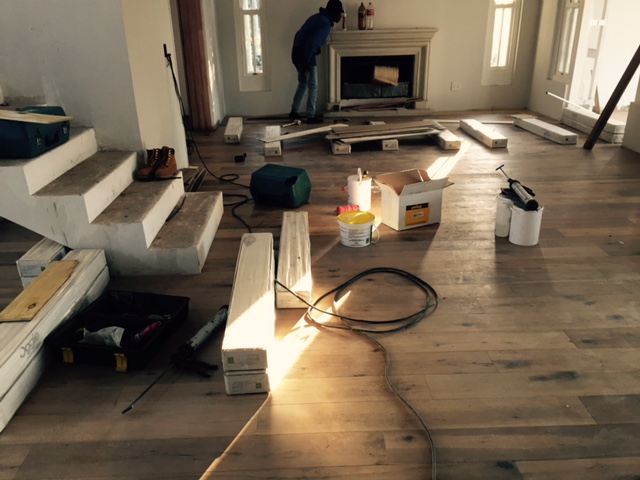

Downstairs flooring.

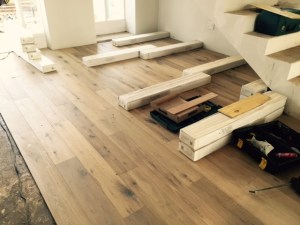

flooring just inside the front door.
Anthony, who is installing the sprinkler system, has kept all his appointments and has managed – despite the chaos – to lay the ‘sleeves’ he needs for his water system. Top soil has been delivered for the front garden. Lawn was supposed to be laid next Monday but it looks as though that might have to be delayed.
The bedroom and dressing room cupboards are almost complete and are looking good.

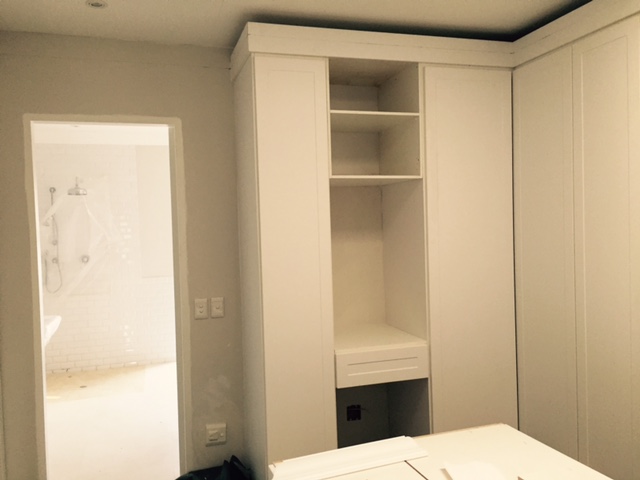

Dressing room south wall.

Dressing room west wall.

Dressing room north wall
I’ll sleep on it tonight but I suspect I’ll have to defer our moving date by at least a week.

Visiting Izzie in her 4th month in a cattery.
